Toolkit contents

Section 9

Presenting use case 1 to the client

The readout is a 60-minute meeting with the executive sponsor and the leadership team, held to agree the four decisions that start the first 90 days. Part 1 of the client deck (slides 3 to 25) is the finished readout for use case 1, and its speaker notes carry the full talk track. Rehearse with it before your first readout, then build your own deck following Part 2, which has the same slides with prompts to replace.

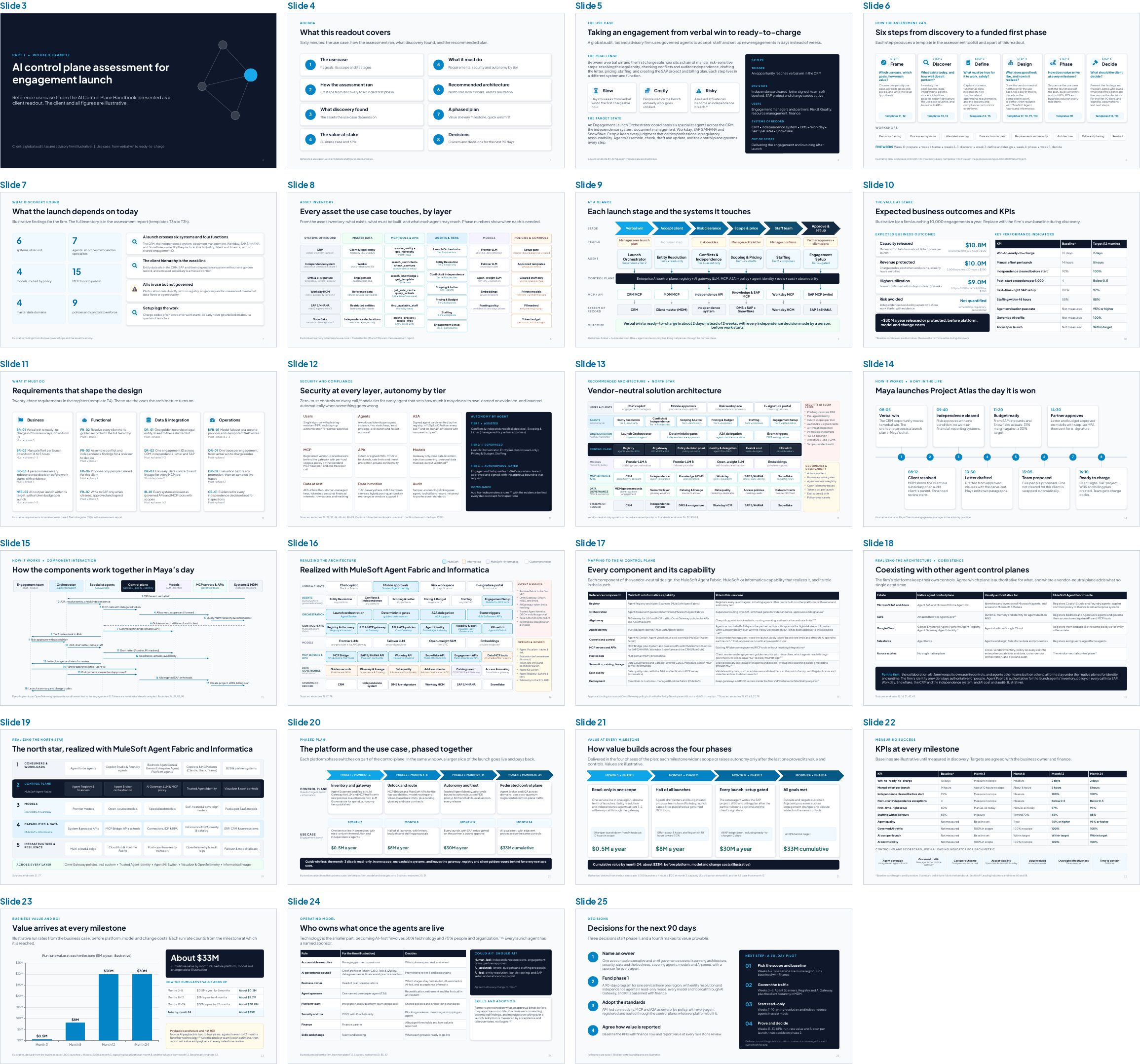

Thumbnails of the use case 1 readout, slides 3 to 25 of the client deck
Figure 17. The use case 1 readout: Part 1 of the client deck, slides 3 to 25. Every slide’s speaker notes carry the talk track (illustrative client and figures).

The storyline

The readout follows the eight parts on the agenda slide, in the order of the six assessment steps: the use case, how the assessment ran, what discovery found, the value at stake, what the solution must do, the recommended architecture, the phased plan and the decisions. The table gives the slides, presenter, timing and templates for each part, and the one message it has to land.

PartSlidesPresenterMinutesTemplatesThe message to land
Opening4Engagement lead3The goal of the meeting is to agree a plan and four decisions for the next 90 days.
1. The use case5Engagement lead3T1Engagement launch can go from verbal win to ready-to-charge in about two business days instead of ten, with people keeping every accountable decision.
2. How the assessment ran6Lead architect2The design and the numbers come from the firm’s own people, documents and data, captured over five weeks and eight workshops in thirteen templates.
3. What discovery found7–9Lead architect5T1, T3A launch crosses six systems and four functions. The client hierarchy is the weak link, and AI is in use but not governed.
4. The value at stake10Engagement lead5T2, T6About $30 million a year released or protected at full run rate, before platform, model and change costs (illustrative).
5. What it must do11–12Lead architect5T4, T5Twenty-three requirements and nine security layers shape the design. People make every independence decision, and every agent has an autonomy tier.
6. Recommended architecture13–19Lead architect13T7–T10One control plane between every agent and every model, tool and system of record, realized with MuleSoft Agent Fabric and Informatica, working alongside the firm’s other platforms.
7. A phased plan20–23Engagement lead11T6, T11Value at every milestone: about $0.5 million a year at month 3, $8 million at month 8 and $30 million from month 12, or about $33 million by month 24 (illustrative).
8. Decisions24–25Engagement lead13T12, T13Show who owns what once the agents are live. Then name an owner, fund phase 1, adopt the standards and agree how value is reported.

The engagement lead opens, frames the value and the plan, and closes with the decisions. The lead architect presents discovery, the requirements, the security and the architecture. Invite the business owner to confirm the baseline on the value slide and the KPI targets on the milestone slide, since a client owns the numbers it has presented itself.

The talk track

The speaker notes in Part 1 of the client deck have the full script for every slide. The points below are the ones to land in each part.

Opening (slide 4, engagement lead)

1. The use case (slide 5, engagement lead)

2. How the assessment ran (slide 6, lead architect)

3. What discovery found (slides 7 to 9, lead architect)

4. The value at stake (slide 10, engagement lead)

5. What it must do (slides 11 and 12, lead architect)

7. A phased plan (slides 20 to 23, engagement lead)

8. Decisions (slides 24 and 25, engagement lead)

Adapting to the audience and the time

Cut the storyline down when you need to, but keep its order, and end every version with the decisions.

AudienceTimeFocus onSlides
Executive sponsor and leadership team60 minThe full storyline and the decisions4–25
CEO, COO or business sponsor alone30 minThe value, the day in the life, the phased plan, who owns what and the decisions5, 10, 14, 20, 23–25
CFO and finance30 minThe value method, the KPIs, value at every milestone against the payback benchmark, and how value is reported10, 21–25
CISO, risk and compliance45 minRequirements, security by layer, autonomy tiers, bound approvals, the kill switch, takeover and audit11, 12, 15, 17, 18, 25
Enterprise architects and platform owners90 minDiscovery, the vendor-neutral design, the realization and coexistence with other agent platforms, with handbook Sections 6 and 77–9, 13–19, 25

Common questions

QuestionHow to answerEvidence
The agent platform already has guardrails. Why add a control plane?Keep them, since they apply inside each platform. The control plane adds what no single platform sees: one registry, one gateway and one audit trail for agents from every platform, so policy does not fragment across vendors.21
Agent 365 (or Amazon Bedrock AgentCore) is already in place. Why another control plane?Keep it authoritative for identity and runtime in its own estate. Agent Fabric is authoritative across estates: the inventory, policy on every call into enterprise systems and data, orchestration across vendors, and cost and audit. Microsoft’s own guidance asks for consistent policy across every agent platform.12,14
Are these numbers real?In the worked example they are illustrative. In a client readout, show which numbers are measured baselines, which are estimates and who agreed them, with the formula for every value, and keep values before platform, model and change costs until the project team has estimated them.
  • T2, T6 and T11
  • Slides 10 and 21–23
What will it cost, and what is the ROI?The project team estimates platform, implementation, model and change costs with the client, and net ROI and payback follow from the cumulative value. Set expectations with the benchmark: typical AI payback is two to four years, against seven to 12 months for other technology, and phasing is how the plan beats it.82
Will agents make decisions on their own?Not the accountable ones. People make every independence decision, agree the terms and approve the setup, while agents assemble, check, draft and update. The one agent that writes to SAP does so only exactly as the partner approved, within the approval’s validity.
  • T5
  • Slides 12 and 15
Does this lock the firm into one model or one agent platform?No. Models are routed by policy through the gateway, agents from any platform connect through open protocols (MCP and A2A),26,27 and the firm keeps its choice of models, agent frameworks, collaboration tools and systems of record.
Where does the firm’s data go? Will it train someone’s model?Model calls go only through the gateway, to models under enterprise terms with zero data retention in approved regions (a dependency of the plan), with sensitive fields masked. Gateways and MCP servers can run inside the firm’s own environment on Runtime Fabric where confidentiality requires.
  • T5
  • T12 dependencies
How are unknown agents found?Agent Scanners discover agents and MCP servers across ecosystems and feed the registry,21 and making the governed path the easy path does the rest. Custom decoy policies, built with the Policy Development Kit, can reveal agents that work outside the governed path.
What happens if an agent goes wrong?Evaluations before promotion test agents against success criteria. At runtime, gateway policies and limits contain an agent that goes wrong, and the Agent Kill Switch stops agent activity quickly.21 People drill the kill switch before any agent goes live at tier 3, a takeover runbook hands the agent’s open work to a named team, and every action is traceable with one correlation ID.
  • T5
  • Slides 12 and 17
Who owns an agent once it is live?A named sponsor owns it from registration to retirement. The sponsor recertifies the agent on a schedule and makes the first call in an incident, and sponsorship moves when people change roles.
Does the design cover the known agentic threats?Every control maps to the OWASP Top 10 for Agentic Applications, and the two gaps no gateway closes alone, what enters the registry and what approvers are shown, have named owners.48
How does this map to the firm’s standards?The handbook’s Appendix C maps each control to ISO/IEC 42001, the NIST AI RMF and the EU AI Act, and the control IDs can go into the requirements and security templates.72,73
Why start read-only? Isn’t that slow?Read-only and propose-only agents release capacity in the first quarter while the controls that later autonomy needs are put in place and proven. Most of the value arrives at month 12, when agents act in systems of record under bound approvals.
How does this relate to Agentforce?Agentforce builds and runs agents inside Salesforce, while Agent Fabric registers, governs, orchestrates and observes all agents, Agentforce included.21
What does the firm need to provide?An accountable owner, a business owner, a finance partner, a sponsor for every agent, data stewards for the client, worker and engagement masters, and architecture and security time for the first 90 days.
  • T12 and T13
  • Slides 24 and 25

After the readout

  1. Send the report and the deck within two business days, with the decisions as agreed in the meeting.
  2. Confirm each decision in writing with its owner and date (T12).
  3. Close the implementation checks with the client: connector coverage for each system, and who builds, tests and supports each custom policy.
  4. Start the 90-day plan. Weeks 1 and 2 set the scope and the baseline, and finance signs the baseline off.
  5. Book the milestone reviews at which the KPIs and the value realized are reported.
  6. Keep the templates live. Agents, APIs and MCP tools from the inventory are registered in Agent Registry, each agent with a sponsor and a recertification date, and the KPIs become the program scorecard.

Rehearsal checklist

  • In the deck you build, leave out slide 2 and any slides you will not present, and keep the template guidance out of the speaker notes.
  • Check every number against the templates, and every illustrative label.
  • Check the standards and regulation dates slide (slide 49) within two weeks of the readout, and update it if anything changed.
  • Keep the superscripts and the sources slide.
  • Rehearse the hand-offs between the engagement lead and the lead architect, and time each part against the storyline.
  • Know what to cut if the meeting is shortened, using the audience table above.
  • Prepare answers to the common questions, with the evidence to show.
  • Bring the report’s executive summary as a one-page leave-behind.
